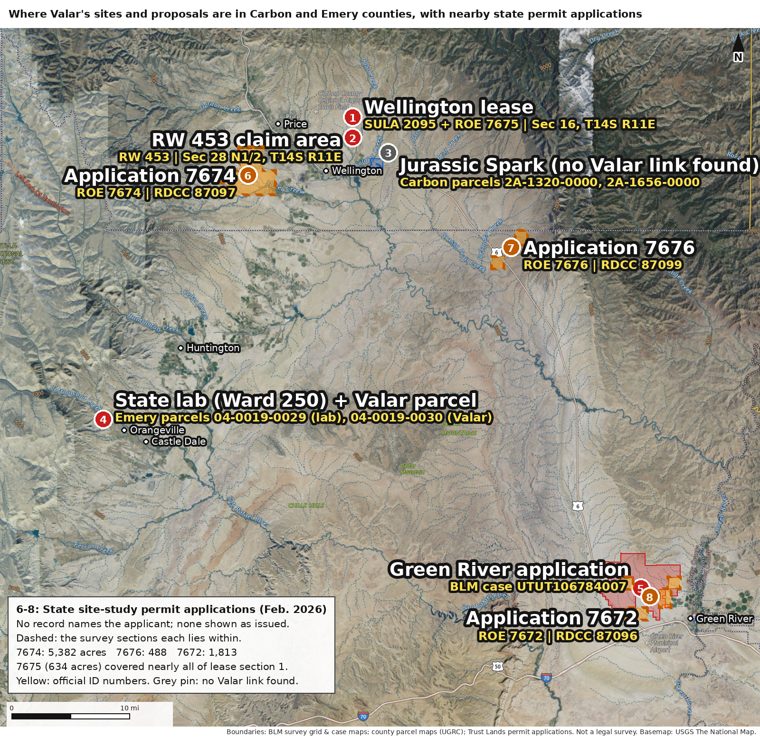

The strongest findings so far, each checked against its source. Every line links to the documents, and each Claims vs Record entry names the record that would settle it.
What you can do about it →“holding the spent fuel from this system for five minutes” gives “the equivalent radiation exposure to receiving a CAT scan”Valar Atomics, 'Valar Atomics is Suing the NRC', April 2025
Valar's April 2025 post describes Ward One as a 100 kWt high-temperature gas reactor using TRISO fuel, with a planned operational lifetime of less than a month, and says: "Our analysis indicates that holding the spent fuel from this system for five minutes" gives the same radiation exposure as a CAT (CT) scan. The post does not say how much fuel is held, how long the reactor ran, how long the fuel cooled, how far it is from the body, or which dose is meant, and the analysis it cites has not been published. The text is the same in the live page (29 September 2026) and in Internet Archive captures of 23 March and 22 July 2026.
| Reactor ran | Fuel cooled | All the spent fuel, whole-body | One fuel element (1/76), whole-body | One 6 cm pebble, whole-body | Skin of the hand touching that pebble |
|---|---|---|---|---|---|
| 30 days | 1 day | 334 | 64 | 0.77 | 316 |
| 30 days | 7 days | 163 | 31 | 0.36 | 147 |
| 30 days | 30 days | 54 | 10.3 | 0.12 | 49 |
| 30 days | 90 days | 14.9 | 2.9 | 0.036 | 15 |
| 30 days | 1 year | 0.99 | 0.19 | 0.0024 | 0.99 |
| 7 days | 1 day | 200 | 39 | 0.48 | 196 |
| 7 days | 30 days | 18 | 3.5 | 0.040 | 16.5 |
| 1 day | 1 day | 75 | 14.6 | 0.18 | 75 |
| 1 day | 7 days | 12.9 | 2.5 | 0.029 | 12 |
| 1 day | 30 days | 3.0 | 0.56 | 0.0064 | 2.7 |
Whole-body = effective dose, the quantity FDA gives for CT, at a point 50 cm from the near surface of the fuel. The last column is the skin dose where the hand touches the pebble: a different quantity, not comparable with a CT's whole-body figure. 'All the spent fuel' and 'one element' (about 100 kg in this model) could not be lifted by hand; they show what the post's words 'the spent fuel' mean taken literally. Scattered photons, beta particles and neptunium-239 are left out, so every figure is a lower estimate. Run length is in full-power days at 100 kW.
With the post's 100 kWt and a run of 1 to 30 full-power days, five minutes with all of the reactor's spent fuel, 50 cm from the body, gives a whole-body effective dose of about 75 to 334 mSv one day after shutdown and 3 to 54 mSv after 30 days, against FDA's typical 1 to 10 mSv for a CT. It comes down to one 10 mSv CT only for a piece holding no more than about 1/1,600 of the core's fission products one day after a 30-day run (1/156 after a one-day run; 1/81 after 30 days of cooling), about 157 g of uranium or 22 pebbles' worth if the core held 250 kg; or, for the whole core, after about 10 to 128 days of cooling. One 7 g pebble gives about 0.8 mSv whole-body, below FDA's typical CT range, while the skin of the hand touching it receives about 316 mSv in the same five minutes, a different dose quantity. Scattered photons, beta particles and neptunium-239 are left out, so these are lower estimates.
Checked: Two independent calculations worked out the doses, each entering the nuclear data separately; a third check re-derived every case in one program and traced each difference between them to a stated modelling choice (distance measured from the fuel's centre or surface, density and size of the fuel ball, how many nuclides were counted, a point-source shortcut). With matching choices the third check reproduces both within 5%, and the two calculations' gamma-ray data agree within about 4%. The total gamma output agrees with the standard decay-heat formula within 3% one day after shutdown. Valar's post was compared across the live page (29 September 2026) and Internet Archive captures of 23 March and 22 July 2026: the text is identical. FDA's CT figures, EIA, Valar's Ward 250 safety paper, the INL pebble benchmark and the NRC's 10 CFR 20.1201 were read from archived copies. The fission-yield, decay and photon-attenuation tables come from the standard evaluated data (ENDF/ENSDF, NIST); the IAEA and NIST servers refuse automated copies and NNDC's answered 'too many requests', so those tables were not re-checked against an archived copy. An error of a few percent in them would move the results by about the same few percent; none of the sensitivity checks moves any case across the CT line. Valar has not published the analysis its post cites, so which reading it used cannot be checked.
Government items carrying the marker had no public record found from the time (no agenda, notice or posting found), or were public without Valar's name; each item gives its date and links its record. 'No public notice found' means none on the state's notice website.
Valar's safety agreement for Ward 250 says its fuel is 4.95% enriched uranium, and its public copy has not changed since at least November 2025. DOE's own shipping review approved sending the reactor HALEU fuel, enriched up to 19.9%. The agreement is marked 'Draft' and says fuel-design changes will be carried into a later safety analysis; that analysis, which may have been updated, was not found in public records.
Keeping everyone 400 meters back would take about 124 acres. No record read says the public is kept off the land beyond the lab. Valar has since bought, or is buying, about 110 acres north of the lab; no record read says whether that covers the 400-meter circle. The 400 meters is the distance Valar's draft safety paper uses for its public-dose math and calls 'the nearest point of public access'; no DOE record read makes it a required boundary, and DOE's review says access is controlled during operations without saying where.
NPR reported on 30 September 2026, citing a Valar proposal to federal regulators that it reviewed, that the plan also includes data centers, a nuclear fuel facility and places to store nuclear waste, with the first reactors in 2028. BLM told NPR it is reviewing the application for completeness. The proposal itself was not found in public records.
The credit is paid only after new state tax revenue comes in. The July 9 agenda did not name Valar. The materials naming it were posted at 1 p.m., after the meeting was scheduled to end, and the minutes, posted with the September meeting, are marked protected under a state law on incentive negotiations.
No approved safety analysis, operating limits, DOE review of them or signed startup approval was found posted, and DOE's occurrence-report database is closed to the public. DOE has said federal teams reviewed contractor safety submittals for the pilot reactors and took part in Ward 250's readiness review before startup; the review documents themselves were not found. Valar, which calls itself 'very open and transparent', has published its draft safety design agreement and its quality program.
Valar's safety agreement credits its non-nuclear prototype, Ward Zero, for key safety points, such as cooling without pumps. No published Ward Zero test data was found. An unlisted page titled 'Ward Zero Whitepaper' contains no Ward Zero data; its text matches a 2019 essay on reactor exports by another author. It may be leftover placeholder text (Valar has not said), and it is still online.
DOE used a 'categorical exclusion': no environmental assessment or impact statement and no comment period on the project, despite formal objections to the exclusion to which DOE had posted no response. Its review left out a fault zone about 15 km away and the Hunter coal plant about 6 miles away. The exclusion is the environmental (NEPA) step only; DOE's safety approval of the reactor is a separate process.
The water district's approved minutes record a staff report that Valar 'tied into the county sewer system without prior authorization' and that its sewer plans 'were not submitted to the State as required'; the request was for restrooms only. No Valar response or later resolution appears in the record read. For the reactor building's fire-code review, state agencies declined to review the plans and recommended a third-party review, and the county has no fire inspector. The March minutes say it 'has been addressed with chiefs and is not currently a concern', not how.
The state's bid notice and its April posting for agency comment named neither Valar nor a nuclear use; the board packets for the August and September hearings did. Carbon's commissioners signed a support letter; how it was approved is not in the records read. The hearings were in Salt Lake City, and no one spoke against it.
A posted notice names Valar Atomics Inc as locator of the RW 453 lode claim (12 Sept 2026). Public mineral records for the area list only sand-and-gravel pits and a carbon dioxide field; a claimant may know of a mineral showing those records do not list. The county and BLM filings due in October and December will state what is claimed.
The state's slides say nuclear waste storage is 'strictly prohibited on the lease'; the memo requires Valar to buy any land it needs for interim spent-fuel storage first, and says such storage would need federal and state licenses.
What holds up: DOE did authorize the reactor, DOE says federal teams reviewed its readiness before startup, it reached criticality on 18 June 2026 (ahead of the 4 July goal), it was flown in without fuel, DOE checked the fuel shipment, and DOE says the fuel type, TRISO, is 'more resistant to neutron irradiation, corrosion, oxidation and high temperatures' than traditional reactor fuels. And a Valar plan for a Carbon County manufacturing hub was in the local paper in October 2025, though no local record read named the site before the state's vote. safe-039 loc-034 dir-031 orig-010
